Commercial Tenant Improvement Permit Process BC
Commercial

Commercial Tenant Improvement Permit Process BC

Transforming a commercial lease space into a functional retail store, office, medical clinic, restaurant, salon, or daycare is a specialized process. Commercial Tenant Improvements (TIs) operate under distinct BC Building Code regulations, barrier-free accessibility mandates, and health authority sign-offs. Here is the complete step-by-step roadmap to commercial permitting in British Columbia.

Commercial Tenant Improvement Process at a Glance

An overview of our code-first approach to commercial tenant improvements, leasehold build-outs, and change of use applications in BC.

Step & LeadKey ActivitiesPrimary Deliverable
1. Code & Feasibility
Canadian Blueprint
Occupancy classification, occupant load calculations, travel distances, exiting widths, and change of use feasibility.Commercial Code-First Feasibility Report
2. Building Design & Drafting
Canadian Blueprint
Space planning, Reflected Ceiling Plans (RCP), barrier-free accessible washrooms, and key life safety plans.Commercial Layout & Accessibility Drawing Set
3. Technical Blueprints
CBP & Coordinating Engineers
Fire-rated demising walls, sprinkler coordination, commercial kitchen grease traps, and mechanical ventilation.100% Intake-Ready Commercial Permit Package
4. Submission & Permits
City, Health Authority & CBP
Digital portal submission, Fraser Health / VCH plan submission, fire department review, and stamped permit release.Approved Commercial Building Permit

Project Roadmap & Scope of Work

Select a phase below to jump to the details

  1. 1
    Code & Occupancy Feasibility Audit
  2. 2
    Space Planning & Accessibility
  3. 3
    Technical Blueprint & Life Safety Engineering
  4. 4
    Municipal Intake & Health Authority Approvals

Overview & Context

Overview

Taking over a commercial shell or renovating an existing leasehold space requires navigating a completely different set of municipal standards than residential construction. In British Columbia, commercial build-outs are governed by strict life-safety, fire separation, and accessibility provisions under the BC Building Code (Part 3 and Part 9).

Whether you are executing an interior office refresh, legalizing a Change of Use (e.g., converting a retail storefront into a restaurant or personal service salon), or expanding a retail chain, here is how the commercial TI permit process works.

Step 1: Code & Occupancy Feasibility Audit

Phase 01

Commercial permits focus heavily on public life safety, occupant loads, and health regulations:

Requirement / Regulatory Check Commercial Tenant Improvement (TI) Residential Permit (For Comparison)
Major Occupancy Classification Mandatory: Group A (Assembly), Group D (Business/Services), Group E (Mercantile), Group F (Industrial). Group C (Residential only).
Occupant Load & Egress Capacity Mandatory: Calculations determining maximum safe customer/staff capacity and door exit widths. Fixed residential room dimension standards.
Barrier-Free Universal Accessibility Mandatory: Wheelchair-accessible washrooms, turning radiuses, door clearances, and lever hardware. Standard residential door/bath sizing.
Health Authority Plan Review Mandatory for Food & Salons: Fraser Health / Vancouver Coastal Health reviews sanitation and sinks. Not Applicable.
Commercial Grease Trap & Kitchen Hood Mandatory for Restaurants / Food Prep: NFPA 96 grease extraction hoods and interceptors. Residential kitchen range hoods only.
Fire Separations Between Tenants Mandatory: 1-hour or 2-hour fire-resistance rated demising walls and fire dampers. 45-min suite fire separations.

Step 2: Space Planning & Accessibility

Phase 02

Before signing a commercial lease or finalizing interior layouts, we conduct an in-depth code audit of the space:

  • Change of Use Verification: If the previous tenant operated a retail store (Group E) and you are opening a restaurant or personal service salon (Group A2 or Group D), the City considers this a Change of Use. This triggers updated occupant load calculations, plumbing fixture counts, and potential sprinkler requirements.
  • Occupant Load & Exit Width Analysis: Calculating how many customers and staff can safely occupy the space based on square footage factors in the BC Building Code. This determines whether you need a single exit door or two widely separated exit doors.
  • Travel Distances & Emergency Lighting: Verifying maximum travel distance to an exit door, illuminated EXIT signs, and emergency battery-pack floodlighting.

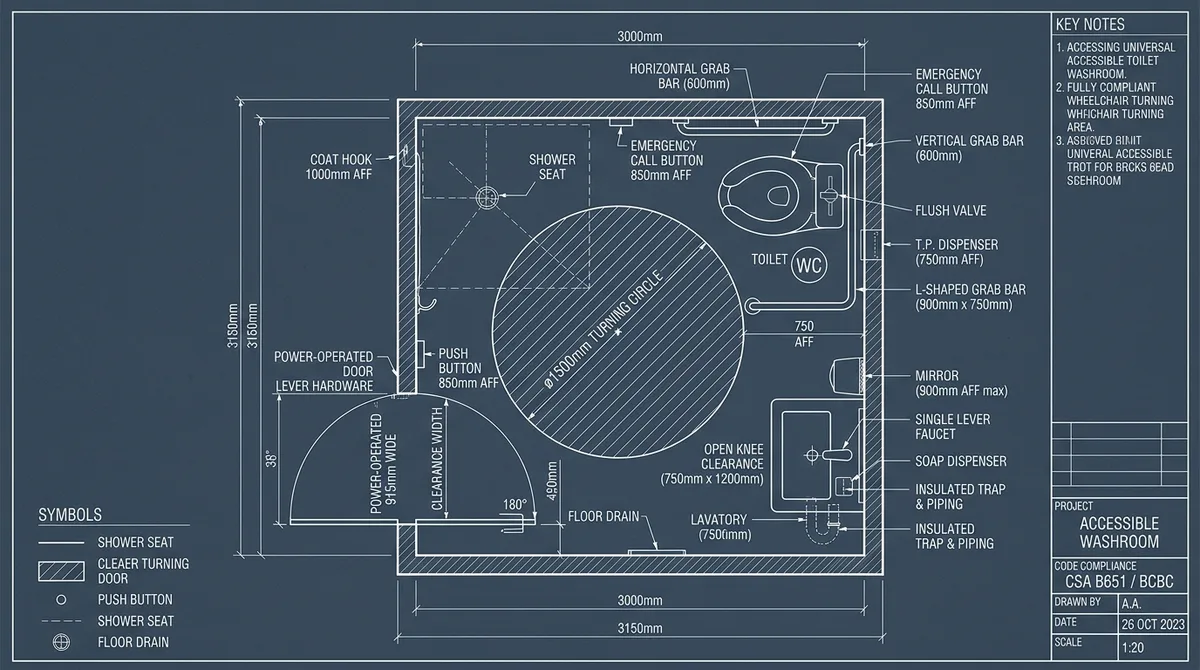

Barrier-Free Accessibility CSA B651 and BC Building Code universal accessible washroom dimensioned CAD floor plan
Universal Washroom Compliance: Dimensioned CSA B651 / BC Building Code accessible washroom CAD drawing showing 1500mm turning radius circle, grab bar clearances, and outward-swinging door.

Step 3: Technical Blueprint & Life Safety Engineering

Phase 03

With code limits established, Canadian Blueprint designs an efficient space layout optimized for your business operations:

  • Barrier-Free Universal Accessibility: Designing accessible washrooms (including grab bars, turning radiuses, and sink clearances) that satisfy the latest BC Building Access Handbook and municipal bylaws.
  • Reflected Ceiling Plans (RCP): Mapping lighting layouts, HVAC diffusers, return air grilles, and fire sprinkler head locations to ensure seamless trade coordination.
  • Life Safety & Key Plans: Providing clear municipal plans identifying fire extinguishers, emergency exit paths, fire separation walls, and electrical service panels.

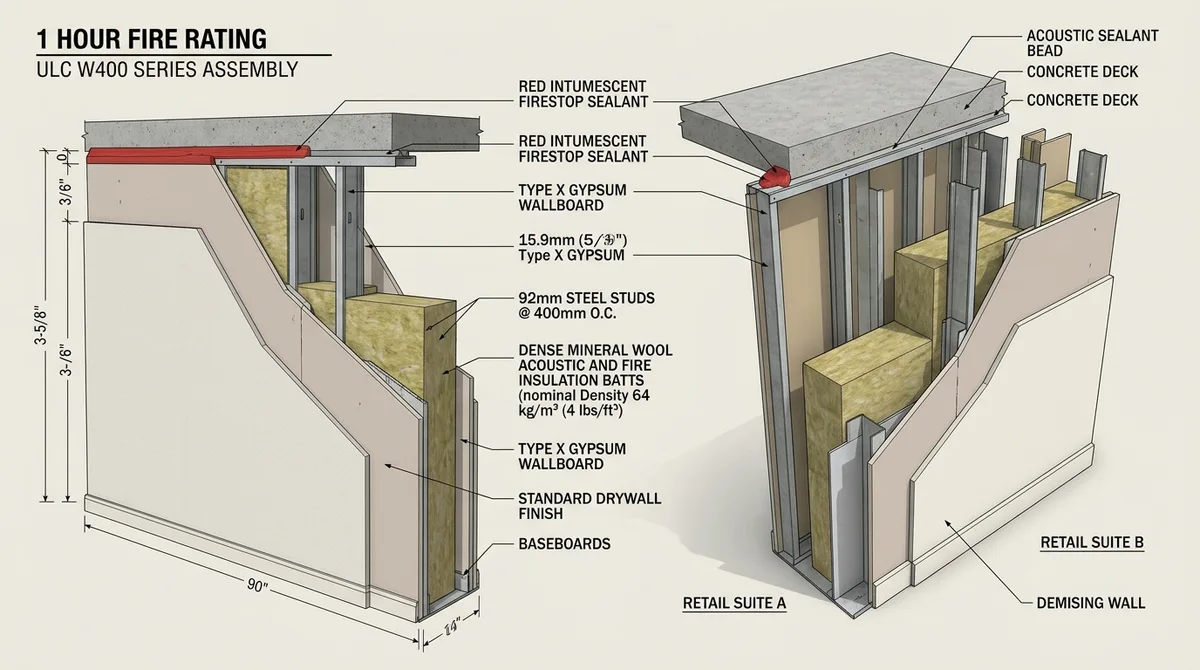

1-Hour Fire Separation 1-Hour fire rated commercial demising wall assembly cross section with mineral wool and firestop sealants
Commercial Fire Separations: 1-Hour ULC fire-rated demising wall cross-section with steel stud framing, dense mineral wool acoustic insulation, and intumescent firestop perimeter seals.

Step 4: Municipal Intake & Health Authority Approvals

Phase 04

Canadian Blueprint creates the full technical drawing package required for municipal building intake and health authority review:

  • Fire-Rated Demising Wall Details: Specifying 1-hour or 2-hour ULC-rated wall assemblies between adjacent commercial tenants, including acoustic insulation to prevent noise transfer.
  • Mechanical & Electrical Engineering Coordination: Coordinating with registered mechanical and electrical engineers for commercial kitchen grease traps, rooftop HVAC units, fresh air makeup systems, and electrical load calculations.
  • Health Authority Drawing Packages: Preparing dedicated plumbing and finish schedules for Fraser Health or Vancouver Coastal Health approval (for restaurants, bakeries, hair salons, spas, and daycares).

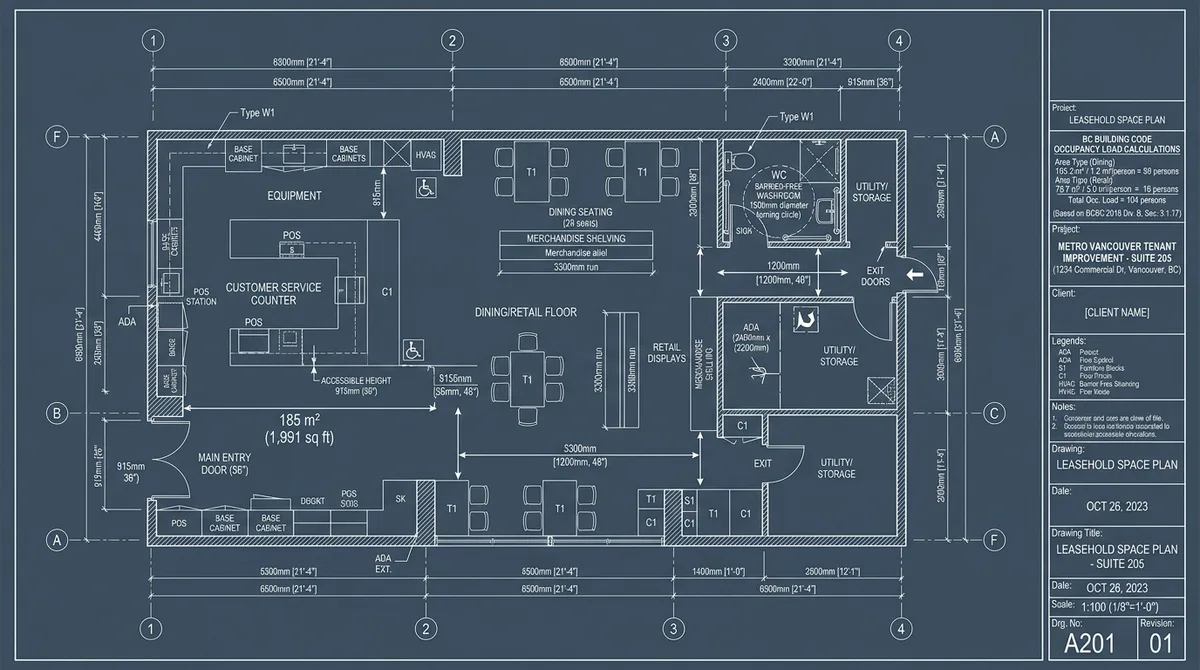

Space Plan & Code Intake Commercial TI architectural blueprint space plan with occupancy load calculations and egress layout
Commercial Space Planning & Code Intake: 2D architectural blueprint layout with BC Building Code occupancy calculations, customer service counter, wide aisles, and life safety exiting paths.

Step 5: Municipal Submission & Permit Issuance

Phase 05

We package your commercial submission into single-layer vector PDFs formatted to digital intake standards:

  • Digital Portal Upload: Submitting via municipal systems like Vancouver ePermits, Surrey MySurrey, Burnaby MyPermits, Richmond ePlan, or Coquitlam QFile.
  • Multi-Agency Circulation: Commercial files are reviewed concurrently by City Building Plan Checkers, the local Fire Prevention Division, and Health Authorities.
  • Deficiency List Management: If examiners request drawing updates, forward the notice directly to Canadian Blueprint. We revise the CAD drawings rapidly to keep your lease timeline on schedule.
  • Full Process Reference: Read our master 8-Step BC Building Permit Approval Process for complete municipal workflow details.

Construction Phase: Commercial Inspection Milestones

Guide

Once your Commercial Building Permit is issued, site inspections must be passed before concealing work and before opening for business:

1. Plumbing Rough-In & Pressure Tests: Waste lines, vents, water supply lines, and commercial grease trap installation tested and signed off. 2. Electrical Rough-In: Conduits, wiring, and emergency lighting circuits passed by Technical Safety BC or City electrical inspectors. 3. Framing & Fire Separations: Steel stud framing, backing for equipment, and fire-rated demising wall drywall inspected before taping and mudding. 4. Fire Alarm & Sprinkler Sign-Off: Fire protection engineers test sprinkler heads, flow switches, and emergency pull stations. 5. Health Authority On-Site Inspection: Health inspectors verify handwash sinks, food prep surfaces, sanitation equipment, and water temperatures. 6. Final Building Inspection: Verifies exit hardware (panic bars), illuminated exit signs, accessibility features, and issues the Commercial Occupancy Permit.

For a complete stage-by-stage guide on municipal inspections, read our Commercial Tenant Improvement Inspections Guide.

Ready to Launch Your Commercial Space?

Guide

From boutique retail stores and corporate offices to bustling restaurants and medical clinics, Canadian Blueprint delivers code-compliant building permit drawings that accelerate commercial tenant approvals across British Columbia.

Canadian Blueprint Logo

Canadian Blueprint Inc.

BC Building Design & Permit Drawings

Published • Updated

Back to Guides

Let's Get Started

Take the next step in your building journey with our specialized design and permit services.

As-Built Measuring
Precise LiDAR scanning
  • 360° Walkthrough
  • Point Cloud Data
  • Digital Twin
  • AutoCAD Floor Plans
  • Elevation Drawings
  • Detailed Sections
Learn More →
Commercial
Business spaces & TI
  • As-Built Measuring
  • Tenant Improvements
  • Change of Use Permits
  • Business Renovations
  • First-Time Business Setup
  • Commercial Space Planning
Learn More →
