Served with a Stop Work Order? BC Permit Recovery Strategy
General Guide

Served with a Stop Work Order? BC Permit Recovery Strategy

A Stop Work Order (SWO) is not a suggestion; it is a legal injunction. Trying to 'talk your way out of it' or sneaking in weekend work will only multiply your fines and trigger a Demolition Order. When a BC municipality halts your project for unpermitted construction or code violations, you lose the benefit of the doubt. To get the red tag lifted, you must pivot immediately from construction to strict regulatory compliance.

The Retroactive Permit Package: What the City Demands

A Stop Work Order resets your project. To lift it, you must submit a comprehensive package that proves compliance with current BC Building Code standards.

RequirementPurposeCritical Detail
BCLS Survey & LiDAR As-BuiltsEstablishes legal setbacks and the exact dimensions of the unpermitted structure.The Survey and As-Builts must perfectly interlink to prove zoning compliance.
Retroactive building permit plansFull floor plans, elevations, and cross-sections of the current 'As-Is' conditions.Must highlight what needs to be altered to meet current BC Building Code.
Structural Engineering (Schedule B)Professional assurance that the framing and foundation meet load codes.Often requires exposing covered work (removing drywall) for the engineer's review.

Project Roadmap & Scope of Work

Select a phase below to jump to the details

  1. 1
    Stop Work Immediately and Secure the Site
  2. 2
    Request the Official Deficiency Report
  3. 3
    Pull the Municipal 'Record Drawings'
  4. 4
    Execute LiDAR As-Built Measuring & BCLS Survey
  5. 5
    Submit the Retroactive Permit Package

Overview & Context

Overview
When a BC municipality posts a Stop Work Order (Red Tag), the project transitions immediately from standard construction to a legal compliance matter. Here is the exact 5-step recovery protocol to halt escalating daily fines, address city deficiency reports, and submit an approved retroactive permit package.

Step 1: Stop Work Immediately and Secure the Site

Phase 01

The moment the notice is posted, tools go down. Do not cover up framing with drywall, and do not try to hide the work. Your immediate next step is to contact the bylaw officer or building inspector listed on the notice. Request the official complaint or reason for the SWO in writing. You need the exact municipal bylaw or BC Building Code infraction they are citing.

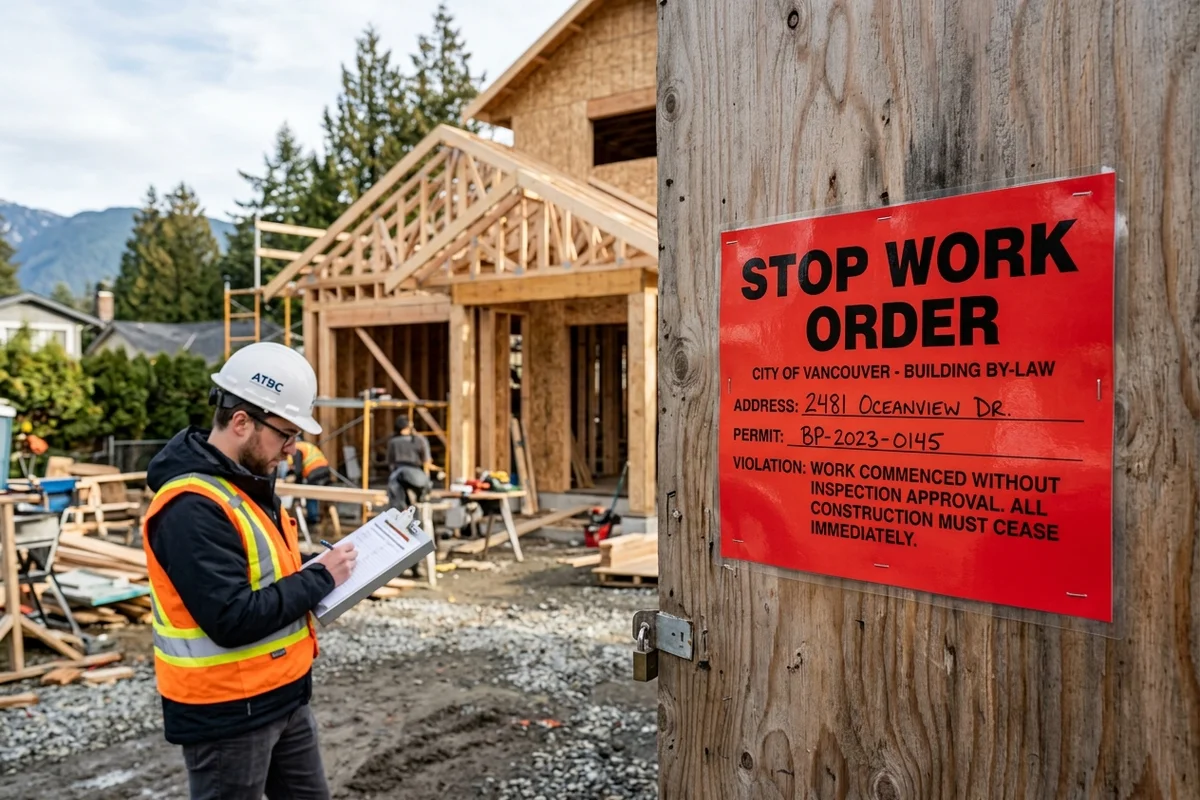

Phase 01 Legal Notice Official Municipal Stop Work Order posted on site
Official Municipal Stop Work Order: Work must cease immediately upon notice posting. The inspector's contact details establish the cited bylaw and code infractions.

Step 2: Request the Official Deficiency Report

Phase 02

Allow the building inspector full access to the site. Your goal here is not to argue, but to obtain a written Deficiency Report. This report is your roadmap. It tells us exactly what the city knows, what they suspect, and the specific parameters required to lift the order.

Step 3: Pull Municipal Archival Record Drawings

Phase 03

Before we can fix the unpermitted work, we need to prove what was legally there before you started. We immediately submit a request to the city archives for the original Record Drawings (the historical blueprints). This establishes the legal baseline of the property. If your unpermitted work altered structural load paths or exceeded allowable Floor Area Ratios (FAR) based on those original plans, we have to account for it.

Step 4: Execute LiDAR As-Built Measuring & BCLS Survey

Phase 04

To draft a retroactive building permit, we cannot use guesswork. The city requires absolute proof of what has been built. This is where two critical data points must interlink:

  • The BCLS Survey: A registered surveyor must map the property lines, locating exactly where your structure sits to prove it does not violate municipal Setbacks.
  • LiDAR As-Built Measuring: We deploy on-site LiDAR scanning to capture the interior and exterior geometry of the unpermitted work.

By overlaying our millimeter-accurate 3D LiDAR data onto the surveyor’s legal boundaries, we create an undeniable plot plan. This combined data proves to the city exactly what exists, down to the centimeter.

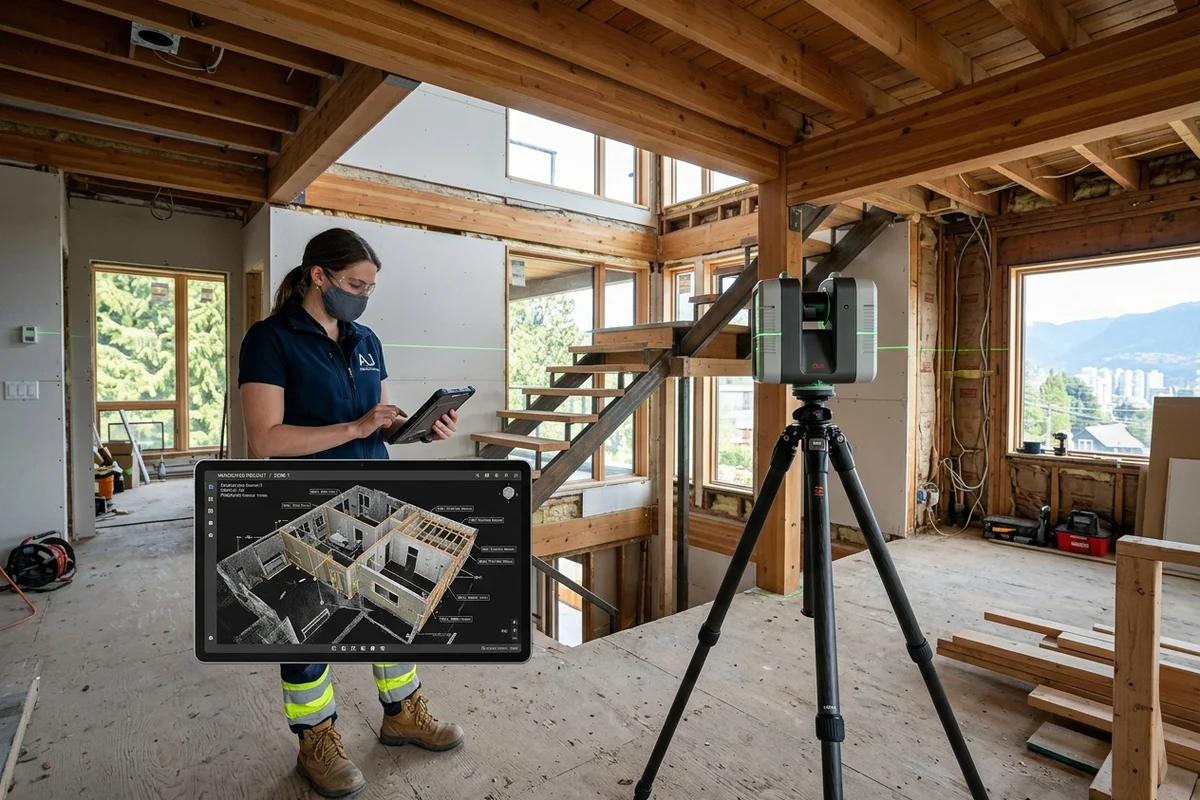

Phase 04 3D LiDAR Scan 3D LiDAR laser scanning inside unpermitted residential build
Precision 3D LiDAR As-Built Scan: Capturing complete interior and exterior structural dimensions to generate CAD drawings matching real-world site conditions.

Step 5: Submit the Retroactive Permit Package

Phase 05

With the As-Builts complete, we draft a full set of building permit plans. Typically, unpermitted work requires a structural engineer to sign off via Schedule B. We coordinate with the engineers, providing them the LiDAR data so they can review spans and point loads. Once the architectural and structural packages are unified, we submit them for a retroactive building permit, turning your liability back into a legal asset.

Phase 05 Structural Sign-off Structural engineer and designer reviewing glulam retrofit on site
Structural Engineering (Schedule B): Reviewing point loads, beam spans, and engineered retrofits to satisfy municipal structural requirements for permit approval.

Don't Guess Your Way Out of a Stop Work Order

Risk Control

If you have been served with a Stop Work Order, every day you wait complicates the resolution. We take over the municipal communication, execute the site measuring, and engineer the compliance strategy to get your project moving again.

Contact Us Immediately for a SWO Review

FAQ: The Cost of 'Continuing Anyway'

FAQ

Will the city force me to tear down the unpermitted work?

Not necessarily. If the work can be proven to meet the BC Building Code and municipal zoning bylaws (like setbacks and density), it can often be retained through a retroactive permit process. If it violates zoning, modifications or partial demolition may be required.

Why do I need to remove drywall for the inspector?

If framing, plumbing, or electrical work was covered before the city could inspect it, they cannot verify it meets safety codes. You will typically be required to expose the work so engineers and inspectors can verify the assemblies.

Can I apply for the retroactive permit myself?

While technically possible, retroactive permits are highly scrutinized. Because the work is already done, municipalities almost always require professional As-Built drawings and Letters of Assurance (Schedules) from registered professionals to absorb the liability. For a detailed breakdown of the immediate actions you should take on your own before professional drafting begins, read our DIY Stop Work Order Resolution Guide.

Canadian Blueprint Logo

Canadian Blueprint Inc.

BC Building Design & Permit Drawings

Published • Updated

Back to Guides

Let's Get Started

Take the next step in your building journey with our specialized design and permit services.

Residential
Homes, suites & outbuildings
  • As-Built Measuring
  • New Custom Homes
  • Home Renovations
  • SSMUH / Multiplex
  • Accessory Buildings & Garages
  • 3D Visualization
Learn More →
Commercial
Business spaces & TI
  • As-Built Measuring
  • Tenant Improvements
  • Change of Use Permits
  • Business Renovations
  • First-Time Business Setup
  • Commercial Space Planning
Learn More →
